Transportation Deployment Casebook/2025/China's HSR
China High-Speed Rail Life-Cycle Analysis
Qualitative:
1 Technology
1.1 Background and Technology Features
High-Speed Rail (HSR) usually means railway systems that run at speeds of more than 250 km/h. China's High-Speed Rail is the biggest high-speed rail network in the world, and it's growing really fast. [1]
1.1.1 High - speed Capability
China's high - speed trains typically operate at speeds ranging from 250 km/h to 350 km/h. Some lines, like the Beijing - Shanghai High - speed Railway, are designed with a maximum speed of up to 380 km/h. This high - speed operation significantly cuts down travel times between cities, for instance, reducing the journey from Beijing to Shanghai to just a few hours.
1.1.2 Stable Operation
Advanced track techs, like ballastless tracks used widely, help keep high - speed trains stable. Ballastless tracks cut down on track deformation and maintenance, giving a smoother ride. Also, advanced train control and vehicle suspension systems make sure trains stay stable even at high speeds, so passengers enjoy a pleasant trip.
1.1.3 Advanced and Intelligent Technology
China's high - speed rail is highly intelligent. The Automatic Train Operation (ATO) system allows for automatic train start - stop, acceleration, and deceleration, enhancing operational efficiency.
CTCS in China's high - speed rail boasts high safety (overspeed protection, fail - safe design), reliable comms (GSM - R), precise positioning, digital smarts (AI - enabled), compatibility, scalability, and real - time control for swift emergency response. (Xiaoliang Wang, & Chunming He. 2017).
1.2 Key Advantages
1.2.1 High Speed and Efficiency
The maximum operating speed of China’s HSR achieves 350 km/h, significantly reducing travel time between major cities. Beijing-Shanghai HSR: 1,318 km in 4 hours 30 minutes, compared to over 12 hours by conventional train.
1.2.2 High Punctuality and Weather Resistance
HSR uses an advanced scheduling system (CTCS and GSM-R), ensuring a punctuality rate above 99%, much higher than conventional trains and flights. When building high-speed rail lines, factors such as terrain and climate will be considered to reduce the impact of weather on the lines.
1.2.3 High Capacity and Extensive Network Coverage
A Fuxing HSR train carries 800-1,200 passengers, significantly higher than airplanes (200-400 passengers). Train boarding is fast (15-30 minutes) compared to 1-2 hours required for flights.
China's high-speed railways have a wide coverage area, connecting large cities with small towns, and promoting regional development.
1.2.4 High security
China’s HSR uses an Automatic Train Control (ATC) system to ensure safety. The ATO and ATC systems cooperate with each other to jointly ensure the safe, punctual and efficient operation of trains.
1.3 Principal Market
China’s HSR market mainly consists of business travelers, leisure tourists, commuters, and those related to regional economic development needs. Different demands from each group improve the fast growth of the HSR network.
2 Context
Before the advent of China’s HSR, China's main transports were conventional railways, air travel, long-distance buses and urban transit. But these had limits in speed, efficiency, capacity and reliability, failing to support China's fast economic growth and urbanization. The rising need for a more efficient, safe and green transport solution spurred HSR development. [2]
2.1 Existing Transport Modes and Their Limitations
2.1.1 Conventional Railways
(1) Low Speed
Conventional trains operated at 80-120 km/h, while express trains (T-category) only reached 160 km/h. For example, Beijing to Shanghai took 12-15 hours, significantly reducing travel efficiency.
(2) Low Comfort
The facilities of conventional trains are rather shabby. The seats are made of hard materials, lacking the function of angle adjustment, and the space is not enough for passengers.
(3) Insufficient Transportation Capacity
The carriage layout and seat arrangement are unreasonable. The close arrangement of five seats in a row result in narrow seat space. The utilization rate of this conventional railway lines is low, which affects the number of train trips and transportation efficiency, especially during the Spring Festival travel rush.
2.1.2 Air Transport
(1) Longer Overall Travel Time
Although civil aviation has a fast flight speed, passengers need to arrive at the airport a long time in advance. They are usually advised to arrive 2 hours or even earlier. The waiting time, the time from the aircraft's parking position to the airport exit after landing, and the time for luggage collection all consume a lot of time.
(2) High Ticket Price
Generally, civil aviation tickets are relatively expensive. They often increase significantly during peak travel periods such as tourist seasons and holidays. Besides the ticket price, passengers may also need to pay additional fees like airport construction fees and fuel surcharges.
(3) Frequent Flight Delays
Affected by factors such as weather, air traffic control, and aircraft queuing, flight delays are frequent, especially for international flights.
2.1.3 Long-Distance Bus Transport
(1) Low Comfort and Low Speed
Long-distance buses have longer travel time, with cramped seating and low service quality.
(2) Less Safety
With complex road conditions and potential fatigue driving of drivers, frequent accidents occur.
2.2 Transport Market Evolution
With the rapid development of urban life and the increasing demand for people's travel, highways and conventional trains cannot well meet people's needs. At the same time, economic development has promoted the acceleration of population flow and the growth of cross-city commuting demand. Conventional trains are not fast enough, and airplanes are not cheap enough. Therefore, driven by demand growth and policy, high-speed rail becomes the best choice. [3]
2.2.1 Population Growth and Rapid Urbanization
With millions population migrating from rural to urban areas, driving demand for intercity transport, China's urbanization rate increased from 26.4% to 49.9%, from 1990 to 2010. Commuter demand increased between major metropolitan areas such as Beijing-Tianjin-Hebei, Yangtze River Delta, and Pearl River Delta.
2.2.2 Government policy in the Railway System
The "Mid-to-Long-Term Railway Network Plan" (2004, 2008) was introduced, highlighting the need for HSR to improve railway development. [4]
2.3 How Did These Factors Stir Interest in New Possibilities?
2.3.1 Filling the Market Gap
The emergence of high-speed rail has filled the gap in the market. For example, within the range of 500 - 1000 kilometers, high-speed rail has great advantages. It is faster than traditional trains and buses, has higher comfort, and is cheaper than airplanes. It is the best choice.
2.3.2 Policy Support and Large-Scale Investment
Many local governments actively promoted HSR to improve regional economies. And with the policy support, lots of companies are willing to invest to the development of HSR.
2.3.3 Environmental Friendliness
HSR are powered by electricity so that can decrease carbon emissions. Also, their compact lines mean less land occupation per unit of transportation volume compared to roads and conventional rail lines.
3 Invention of High-Speed Rail
The invention of HSR combined a lot of professional expertise from many high-tech fields such as track systems, train manufacturing, signaling control, electrification, and operational management.
3.1 Technology Integration
The development of HSR required mechanical engineering, electrical systems, track laying, automation, and aerodynamics.
3.1.1 Early Integration from Different Countries
The development of China’s HSR learned expertise from Japan’s Shinkansen, Germany’s ICE and France’s TGY, etc.
In the early years, China's HSR learned from these countries by exchanging market for technology. The HSR of these countries have different advantages in track technology, train power, signal control, and passenger comfort.
3.1.2 The Improvement of The Initial Technology
(1) Initial Challenges
Initially, China introduced HSR technology from abroad. But in the face of the early experience of adapting to China's territory, complex terrain, and large - scale demands, it was instantly adjusted. In addition, imported HSR technology was expensive, requiring cost reductions in maintenance and construction. So, the development of China’s HSR had to shift from relying on imports to independent design.
(2) Independent Innovation and Design
CRH Series: based on imported technologies and designs (Japan’s e2-1000), China enterprises have optimized and improved many aspects such as power, control system and body design of trains. Finally, CRH Series (Harmony Trains) were created.
Fuxing Trains: 100% designed by domestic, reaching 350 km/h with 10% lower energy consumption.
(3) Shift from Initial to Predominant Technology
Table 1. Train Technology Evolution
| Period | Main Train Models | Maximum Speed | Characteristics |
| 2003 - 2007 | CRH1, CRH2, CRH3, CRH5 | 250 - 300 km/h | Improved based on foreign products |
| 2010 | CRH380A | 350 km/h | Optimized and designed by China |
| 2017 - Present | Fuxing CR400AF/BF | 350 km/h | Completely independently developed |
CRH1-5: Based on imported designs (Bombardier, Japanese, and German technology).
CRH380A (Harmony Trains): Optimized for better high-speed stability.
Fuxing CR400AF/BF: 100% designed by domestic with Chinese characteristics, reaching 350 km/h.
Table 2. Upgrades in Signaling and Control Systems
| Year | System | Description |
| 2007 | CTCS - 2 | Adopted European train control technology for basic automation |
| 2015 | CTCS - 3 | 100% designed by domestic, supporting 350 km/h operations with enhanced safety |
4 Early Market Development
Early, the high - speed rail market developed mainly in economically developed and high-density areas where intercity transportation demand was high. Its initial market niches were business travelers and long - distance passengers. They demanded fast and comfortable travel, which traditional rail and road transport couldn't easily bring.
4.1 Initial Market Niches
4.1.1 Business Travel Market
Business people need travel to be timely and convenient. Target users included government officials, executives, and intercity business professionals who required efficient and punctual transportation. HSR are highly punctual. Their stations are often near urban areas or transportation hubs, so it's easy to quickly get to destinations for business. Also, the comfortable ride lets business people handle work on the go. So, it's a top choice for business trips.
4.1.2 Long-Distance Travel Market
HSR is faster than traditional railways, cutting travel time. For instance, Beijing-Shanghai HSR reduced travel time from 12-15 hours to 4.5 hours, improving passenger experience. On short - and medium - distance routes, it's more convenient at stations and has more stable prices than planes. So, it draws many long - distance travelers between cities, meeting their need for fast and comfortable trips.
4.2 Functional Enhancement
4.2.1 Improving Passenger Efficiency
The primary aim of HSR was to better meet the needs of business people and cities along HSR routes for efficient travel and a comfortable environment. HSR rides are quieter and smoother, making it more comfortable than conventional trains and buses. Most of HSR trains also offer free Wi-Fi, and also have power outlets, onboarding dining to better meet needs.
4.2.2 Functional Discovery
The development of high-speed rail has driven economic growth in cities and surrounding areas and at the same time attracted tourists from other places.
(1) Intercity Commuter Market
With the increase in HSR stations, intercity commuting emerged, particularly on short-distance routes like Beijing-Tianjin and Shanghai-Suzhou. So, it enabled small-city residents can work in major cities but live in small city, reducing housing pressure in metropolitan areas. For instance, Suzhou, near Shanghai, attracting investment and population flow from HSR.
(2) Regional Economic Development
HSR improved tourism economy. For instance, Hangzhou, Suzhou have a significant increase in tourism due to easier access via HSR. In addition, companies also can locate their factories in lower-cost cities along HSR route while keeping headquarters in major cities.
5 The Role of Policy
5.1 Borrowed Policies from Precursor Models
China adopted HSR technology and operational models from Japan (Shinkansen), France (TGV), and Germany (ICE). Through joint venture production methods, for example, early CRH trains were produced through cooperation between CSR (a Chinese company) and enterprises such as Kawasaki Heavy Industries of Japan, Bombardier, and Siemens.
5.2 Innovative Policies
China innovated the “market - for - technology” policy. Its large domestic market attracts foreign advanced HSR tech firms to cooperate. Meanwhile, it demands technology transfer, quickly improving domestic HSR tech levels.
In 2004, China put forward the Mid-to-Long-Term Railway Network Plan, proposing the construction of a high - speed rail network of "four vertical and four horizontal" for the first time. A few years later, it was expanded to "eight vertical and eight horizontal" to cover a wider range of areas. Simultaneously, the government provided special funds and bank loads to better develop HSR.
5.3 Imposed or Sanctioned Policies
The government enforced the Railway Law and Land Management Law to secure land for HSR construction. Many HSR projects required large-scale land acquisition, with local governments aligning with central policies.
Early HSR projects were controlled by China Railway Corporation (formerly the Ministry of Railways) to keep government dominance. Private and foreign firms were restricted from operating HSR services, ensuring state monopoly.
5.4 Policies That Were "Locked In" During This Time
In the early stage of development, the investment, planning, and construction of HSR were completely led by the government. Although social investment was permitted later, state - owned enterprises still dominated, which led to a slow progress. [5]
Since 2007, China has independently developed high - speed rail tech, designing train models. The tech - autonomy policy accelerated construction. In 2017, the Fuxing was fully independently developed and exported to many other countries.
6 Growth of High-Speed Rail
6.1 Roles of Public and Private Sectors
Public Sector: Led by the government, the National Development and Reform Commission and China Railway Corporation handle planning and financing, providing financial support. [6]
Private Sector: Social capital gradually enters, supporting some local HSR projects, but overall impact is limited.
6.2 Policy Issues and Solutions
6.2.1 Funding Issues
Early HSR construction relied on government investment, causing high debts.
Solution: Introduce bank loans, local government financing, and try to attract social capital.
6.2.2 Land Acquisition
Some projects involved large-scale demolitions, leading to public dissatisfaction.
Solution: The government formulates compensation mechanisms, increases transparency, and strengthens local coordination.
6.3 Impact of Policy Environment
In 2008, the global financial crisis prompted the government to increase HSR investment as an economic stimulus measure.
The "Eight Vertical and Eight Horizontal" plan promoted the layout of the national HSR network to ensure balanced regional development.
Environmental protection policies encouraged HSR to replace short-distance flights, reducing carbon emissions.
7 Maturity of High-Speed Rail
High - speed rail model, its development in the mature stage has the following characteristics.
Network layout: China has built an "Eight Vertical and Eight Horizontal" network, connecting many cities, covering a wider range, and enhancing intercity exchanges in economy and culture.
Technological improvement: Technologies are constantly upgraded for higher speed, safety, and comfort. For instance, Fuxing trains not only runs faster but also advances in intelligence and energy - saving.
Market expansion: The market has broadened. Besides serving business and long - distance travel, it also attracts more short - distance travelers and those on tourist trips. In addition, related industries like express delivery via HSR have also developed.
7.1 Adapting to Changing Markets
At present, the demand for HSR in China has shifted from long-distance business travelers to intercity commuting and tourism markets. It introduced the flexible pricing models (dynamic pricing) to meet different passengers’ needs and improve occupancy rates.
7.2 Changes in the Competitive Conditions
7.2.1 Competing with Airplane Travel
HSR has replaced flights for routes under 1,000 km, but air travel still domains for distances over 1,500 km.
HSR can improve their competitiveness through enhance train speed and optimize service quality.
7.2.2 Competing with New Energy Vehicles (For long-distance travel)
Rising HSR ticket prices may pushed some travelers to use electric vehicles for long-distance travel. Although self-driving requires bearing tolls and facing the risk of fatigue driving, the advantages of comfort and privacy it brings are great.
In the future, multi-modal transportation plans such as high-speed rail + intercity bus may be launched to solve the problem of the last mile. [7]
7.3 Lock-in Constraints on Adaptation
7.3.1 State-Owned Monopoly Constraints
State - owned enterprises still dominated the HSR market, which led to a slow progress, limiting market competition.
7.3.2 Financial Constraints
HSR development rely on government investment, leading to lack funds to invest. Meanwhile, the government may increase ticket prices, therefore passengers may cannot afford it.
7.4 Opportunities to Re-invent HSR
7.4.1 Technological Advancement
Vigorously research and develop maglev technology to increase the speed of HSR from 350 km/h to above 600 km/h and improve the travel efficiency between cities.
7.4.2 Business Model Innovation
The high-speed rail + logistics model can be adopted. Use the remaining capacity of high-speed rail to transport express deliveries, improve delivery efficiency, optimize resource allocation, and indirectly reduce traffic congestion. Actively develop the surrounding areas of high-speed rail stations to provide one-stop services such as catering and accommodation for traveling passengers and improve the urban economy. [8]
Quantitative:
In order to analyze the development trajectory of China's HSR, we need to cover the complete life cycle of HSR development. At the same time, since HSR has not yet entered the decline phase, it is divided into the following three stages.
Table 3. Lifecycle Stages of China High-Speed Rail
| Phase | Time Period | Description |
| Birthing Phase | 2004 - 2008 | HSR planning and the launch of the first batch of lines |
| Growth Phase | 2012 - 2020 | Rapid expansion phase, completion of the "Four Vertical and Four Horizontal" network, and significant increase in HSR mileage. |
| Mature phase | 2021 - present | Entering the "Eight Vertical and Eight Horizontal" optimization stage, focusing on operational efficiency and technological innovation. |
1 Define the Research Object and Required Data
1.1 Research Object
China’s HSR system
1.2 Status Measure
Table 4. Required Data
| Data Type | Explanation | Unit |
| HSR Total Operating Length | The total length of China's HSR each year | Kilometer (km) |
| HSR Passenger Volume | The total number of passengers taking HSR each year | Hundred million person - times |
2 Data Collection and Organization
According to the data provided by China State Railway Group, statistical yearbooks, and news reports, the total mileage and passenger volume of China's high-speed railways are shown in the table. Since China's first truly high-speed railway began operation in 2008, relevant data is missing before that.
Table 5. China HSR Development Data (Key Years)
| Year | HSR Total Operating Length (km) | HSR Passenger Volume (100M trips) |
| 2008 | 1035 | 128 |
| 2012 | 10111 | 486 |
| 2016 | 22000 | 1443 |
| 2024 | 48000 | 3272 |
| 2030 (predict) | 60000 | 4300 |
3 S-Curve Analysis for China's High-Speed Rail Development
We used the three-parameter logistic function to fit the growth of high-speed rail:
where:
is the status measure, (e.g. Passenger-km traveled)
is time (usually in years),
is the inflection time (year in which 1/2 is achieved),
is saturation status level, (Choose the maximum length of the HSR system that you have recorded in the data)
is a growth rate coefficient to be estimated.
4 Linear Regression Model Estimation
we applied linear regression to estimate the growth trend of China's high-speed rail (HSR) passenger volume and determine its inflection year
4.1 Regression Model
We used a single-variable linear regression (OLS, Ordinary Least Squares) for estimation:
Where,
is set to 4.3 billion passengers (projected for 2030).
4.2 Regression Results
The following data is calculated by Excel:
Table 6. Summary of Calculation Results
| Parameter | Calculated Value |
| (Growth Rate Coefficient) | 0.2989 |
| (Intercept) | -603.56 |
| (Inflection Year) | 2018.96 |
| R2 | 0.9803 |
The regression results show HSR passenger volume growth trend follows the S - curve model, with the inflection point around 2019.

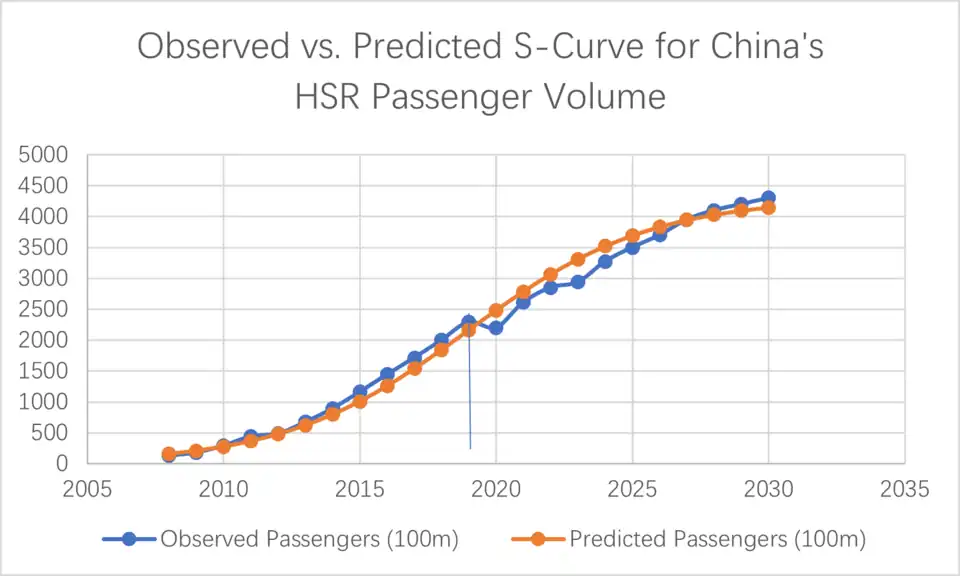

Figure 1. S-Curve for China’s HSR Passenger Volume
4.3 Prediction Validation and Lifecycle Stage Classification
Based on the S-curve regression model results, we compiled the observed and predicted data of China's HSR passenger volume, as follows:
Table 7. Observed vs. Predicted Data (partial)
| Year | Observed Passenger Volume (100M trips) | Predicted Passenger Volume (100M trips) |
| 2008 | 128 | 156 |
| 2013 | 672 | 619 |
| 2014 | 893 | 795 |
| 2019 | 2290 | 2163 |
| 2020 | 2203 | 2481 |
| 2025 | 3500 | 3693 |
| 2030 | 4300 | 4147 |
It proves the S-curve model's effectiveness.
4.4 China’s HSR Lifecycle Phases
Based on the data (observed and predicted passenger traffic) and key development events, we can more accurately delineate the life cycle stages of high-speed rail.
Table 8. China’s HSR Lifecycle Phases
| Phase | Time Period | Key Event | Data Support |
| Birthing Phase | 2008 - 2013 | First HSR line opened, initial market development. | Observed and predicted values remain low, slow growth |
| Growth Phase | 2014 - 2019 | “Four Vertical and Four Horizontal” forming | R² = 0.98, follows S-curve rapid growth pattern |
| Maturity Phase | 2020 - present | “Eight Vertical and Eight Horizontal” structure | Predicted values indicate slowing growth, approaching 4.3 billion saturation level |
5 Conclusion
5.1 Key Period
2008 - 2013 marks the Birthing Phase, when HSR operations began, and market cultivation took place with relatively low passenger volume.
2014 - 2019 represents the Growth Phase, characterized by rapid expansion of the HSR network and exponential passenger volume increase, aligning with the S-curve's rapid growth stage.
2020 - 2030 defines the Maturity Phase, where the network is optimized, growth slows down, and by 2030, passenger volume is expected to reach 4.3 billion trips, indicating saturation.
5.2 Future Outlook and Challenges of China's HSR
China’s HSR passenger volume is expected to stabilize around 2030, reaching 4.3 billion trips, with slower growth marking the transition to a mature phase. As the “Eight Vertical and Eight Horizontal” network nears completion, the focus will shift from expansion to operational optimization, intelligent scheduling, and service improvements, along with extending HSR to smaller cities for enhanced regional connectivity. Additionally, China may strengthen international cooperation, particularly under the Belt and Road Initiative, to expand its global HSR market.
However, challenges remain, including high operational costs, fare pressure, increasing competition, and technological disruptions. The rise of new energy highways and low-cost air travel could divert passengers from HSR, while emerging technologies such as maglev trains and autonomous HSR may reshape the industry. To sustain long-term growth, China’s HSR must focus on network optimization, smart operations, and international expansion while continuously driving technological innovation.
Reference
[1] Julga, G. (1984). Problems of operational planning for fires connected with an underground rail transport system — The Hamburg high speed railway. Fire Safety Journal, 8(1), 53–61.
[2] Xiaoliang Wang, & Chunming He. (2017). Safety function design and application of CTCS on-board equipment in high-speed railway of China. 2017 International Conference on Electromagnetics in Advanced Applications (ICEAA), 677–679.
[3] Nagoya Railroad : [Delayed]The Meitetsu Group’s New Management Vision, Vision for 2040, Mid-to Long-term Management Strategies, and Mid-term Management Plan(FY2024-FY2026). (2024). In News Bites - Transportation. News Bites Pty Ltd.
[4] Engineering - Mechanical Engineering; New Mechanical Engineering Findings from Jiangsu University Described (Development of a Digital Control System for a Belt-driven Starter Generator Segmented Switched Reluctance Motor for Hybrid Electric Vehicles). (2020). In Electronics Newsweekly (pp. 1981-). NewsRx.
[5] Veis, S., Predrag, D., & Srecko, C. (2011). DEVELOPMENT AND STAGES OF INVESTMENT PLANNING AND ASSIGNEMENT OF CONSTRUCTION IN INVESTMENT BUILDING. Journal of Engineering Studies and Research, 17(3), 83-.
[6] Gustavson, M. (2014). Auditing Good Government in Africa: Public Sector Reform, Professional Norms and the Development Discourse (2013th ed.). Palgrave Macmillan.
[7] RB Rail - Rail Baltica II High Speed Rail: Riga Central Multimodal Public Transportation Hub - Latvia - Project Profile. (2017). In Timetric. GlobalData plc.
[8] New Transportation Logistics Findings from Beijing Jiaotong University Discussed (Distribution Planning Problem for a High-speed Rail Catering Service Considering Time-varying Demands and Pedestrian Congestion: a Lot-sizing-based Model and ...). (2019). In Journal of Transportation (pp. 163-). NewsRX LLC.
